eode docs
Core features

Reading results

What the answer means, where every number came from, and how to tell a real result from a thin one.

A solve gives you one number and a lot of context. This page covers how to read both.

The headline

Every result leads with the objective: Best answer: $6,400 — the value of the best plan the model found, in your currency, alongside solve time and iteration count. NPV-style models show Best NPV with the discount rate in the tile label. When a model operates in one currency and reports in another, the panel states the base currency and the rate used.

The narrative

Underneath sits the result in words — what the plan does, what it's worth, and which limits are binding. The Candle Workshop example reads:

The optimal plan makes 300 Classic and 100 Deluxe candles for $6,400 total contribution ($3,600 Classic + $2,800 Deluxe). BOTH constraints bind simultaneously: all 200 kg of wax (120 kg Classic + 80 kg Deluxe) and all 300 labor hours (150 hr each) are fully consumed.

"Binding" is the useful part: a constraint that's fully consumed is what's stopping a better answer. Those are the levers worth attacking — add wax, add hours, or change the mix.

KPI tiles

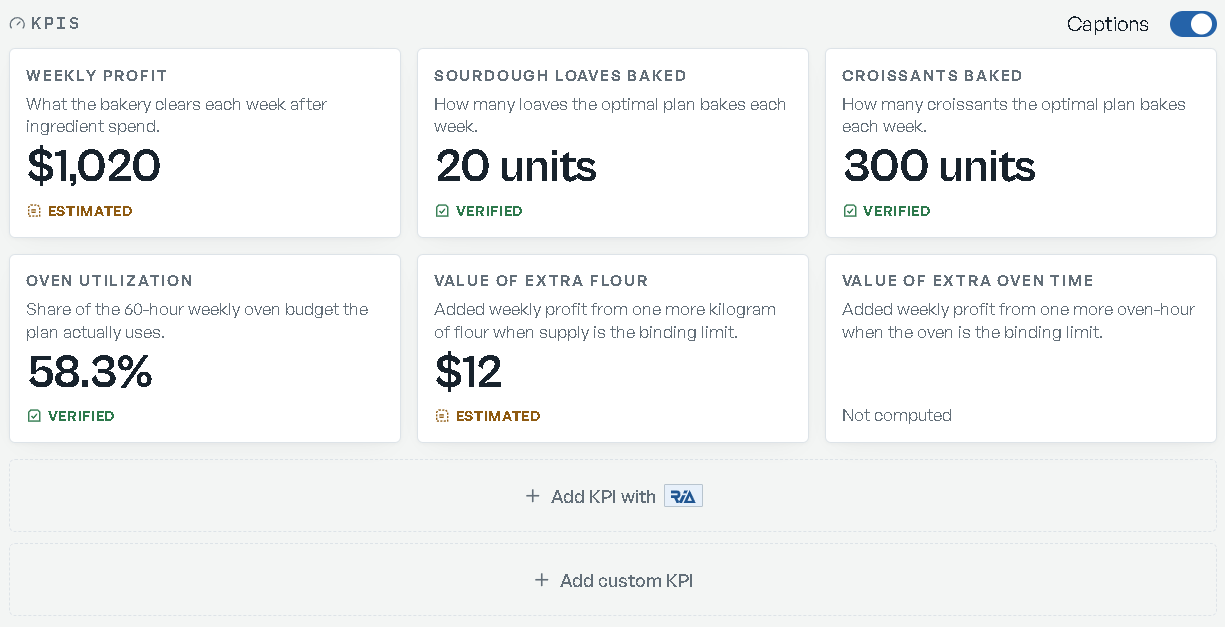

KPI tiles with their descriptions

Each KPI shows its value plus what it means in your business — "What the workshop clears each month after wax, wick, and labor spend on the optimal candle mix." Large currency values abbreviate ($1.24M) with the full figure on hover. Against Base, each tile shows its delta:

  • = base — unchanged.
  • +$420 vs base — currency delta.
  • +3.2 pp vs base — percentage-point delta.

Click a tile to trace the number to the parts of the model that produced it.

Value-of-more tiles

Some KPIs answer "what would more of this be worth?" — for example "Value of an extra production hour: how much more profit one additional hour of production capacity would unlock — flags whether adding shifts pays off." Read these as the price you should be willing to pay for more capacity, not as a forecast.

When there's no answer

An infeasible scenario means your requirements collide — no plan satisfies all of them. Diagnose explains which requirements conflict, the size of the shortfall, and what relief would unblock it. See Scenarios & what-ifs.

How much to trust it

Two mechanisms keep results honest:

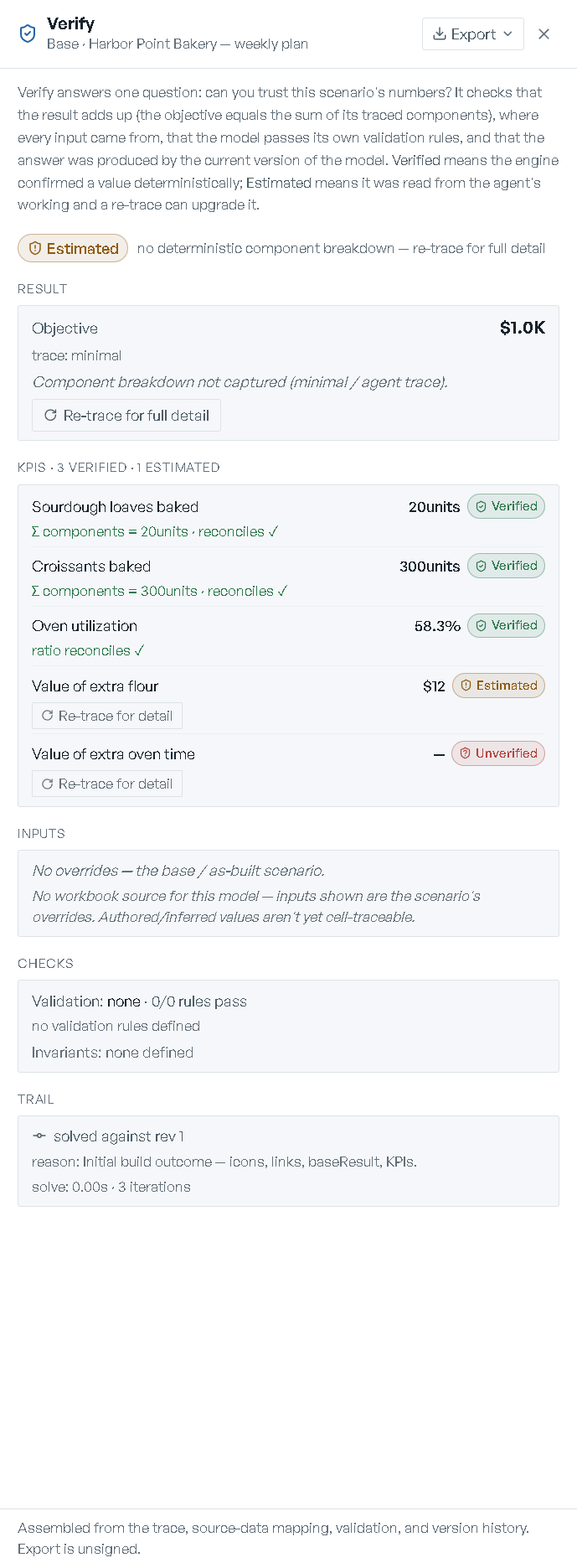

  • Verify builds an evidence record — the result, the inputs it used, the checks run, and the trail — exportable for review outside eode. Results start as Estimated; verification re-loads the model, re-solves, and pulls a deterministic per-component breakdown to reach Verified.
  • RIA Review (on workflow-run stages) tags each of its findings with provenance — solver, rule, your edit, vs base — and a confidence level: certain, likely, or worth a look.

If RIA flags a caveat about its own model, that's the system telling you where the model is thin. Read the caveat before you act on the number.

On this page
